How Hysincere Makes and Tests LiFePO4 Battery Packs

Employees and production equipment in a Hysincere battery pack manufacturing workshop

Every LiFePO4 battery pack we build goes through the same sequence: incoming cell inspection, cell sorting and matching, connection and assembly, BMS integration, charge-discharge and aging tests, and a final check before packing and shipping. Below we walk through each step and explain how to read the inspection reports you receive.

The packs are built at Hysincere‘s factory in Dongguan. The Dongguan factory was set up in 2018, and a new 10,000 m² facility opened in 2023. As of October 2026, we have more than 200 employees, with R&D, process engineering, production and quality teams working together on pack development, manufacturing and testing.

Incoming inspection comes first

When purchased cells arrive, they go through incoming quality control (IQC). The material identity and appearance are checked first, followed by the key items set out in the specification. Nonconforming cells are labeled and quarantined, then reviewed for disposition.

Cells that pass are sorted and matched. Voltage, internal resistance and capacity are measured, and where needed, cells are rested for a period to check self-discharge. They are then grouped according to the series-parallel design and the matching criteria. Matching isn’t just about putting cells with similar voltages together. The aim is for every cell in a group to behave consistently once it is connected in series and parallel. The limits depend on the cell type, and every batch has inspection records.

Before production starts, operators check the parts against the drawings and bill of materials, inspect the fixtures and load the correct test program. The batch continues only after the first unit has been checked and approved.

Model changeovers call for extra care. Two packs can share the same voltage and capacity but use different terminals, harnesses or BMS settings. So at every changeover, leftover material from the previous batch is cleared, labels are changed, and materials and programs are checked again.

Connecting, assembling and installing the BMS

Matched cells are connected, then fitted with insulation, wiring harnesses and the enclosure. The connection method depends on the materials and structure of the cells and connectors. The processes we use include laser welding and ultrasonic metal welding, and depending on the design, potting, conformal coating or ultrasonic sealing of the enclosure.

In-process checks during assembly focus on a few points: correct polarity, sound connections, full insulation coverage, and secure fixing of the cells and wiring. Models with fasteners or seals are also checked for tightening and sealing. Any rework is recorded, and the affected items are inspected again.

The BMS (battery management system) monitors voltage, temperature and other data and steps in with protection when something goes wrong. During assembly, we check the board version, sense wires, temperature sensors, firmware and parameters. For models with communication or a display, we also confirm that these functions work properly.

An AGV battery development project we worked on shows why the BMS has to be considered together with the equipment. An AGV (automated guided vehicle) reads battery data through its controller, and during operation it has to work together with the battery’s protection functions. In that project, the engineering team first agreed with the customer on what data the BMS sends to the controller, what conditions trigger protection, and how the equipment recovers once protection is released. At the sample stage, the battery was installed in the equipment to check communication, protection and state changes, along with mounting points, harness routing and service access.

That’s why “needs communication” on its own gives engineers little to work with. It’s more useful to explain what data the equipment needs to read and what it should do with it: for example, at what charge level it goes back to charge, and whether an over-temperature alarm should slow it down or stop it.

What finished packs are tested for

The photo below shows the test area at our factory, with battery packs connected to test equipment. At this stage, each model goes through charge-discharge, aging, protection and functional tests according to its inspection plan. If a result is abnormal, the cause is found and dealt with, and the pack is retested as required.

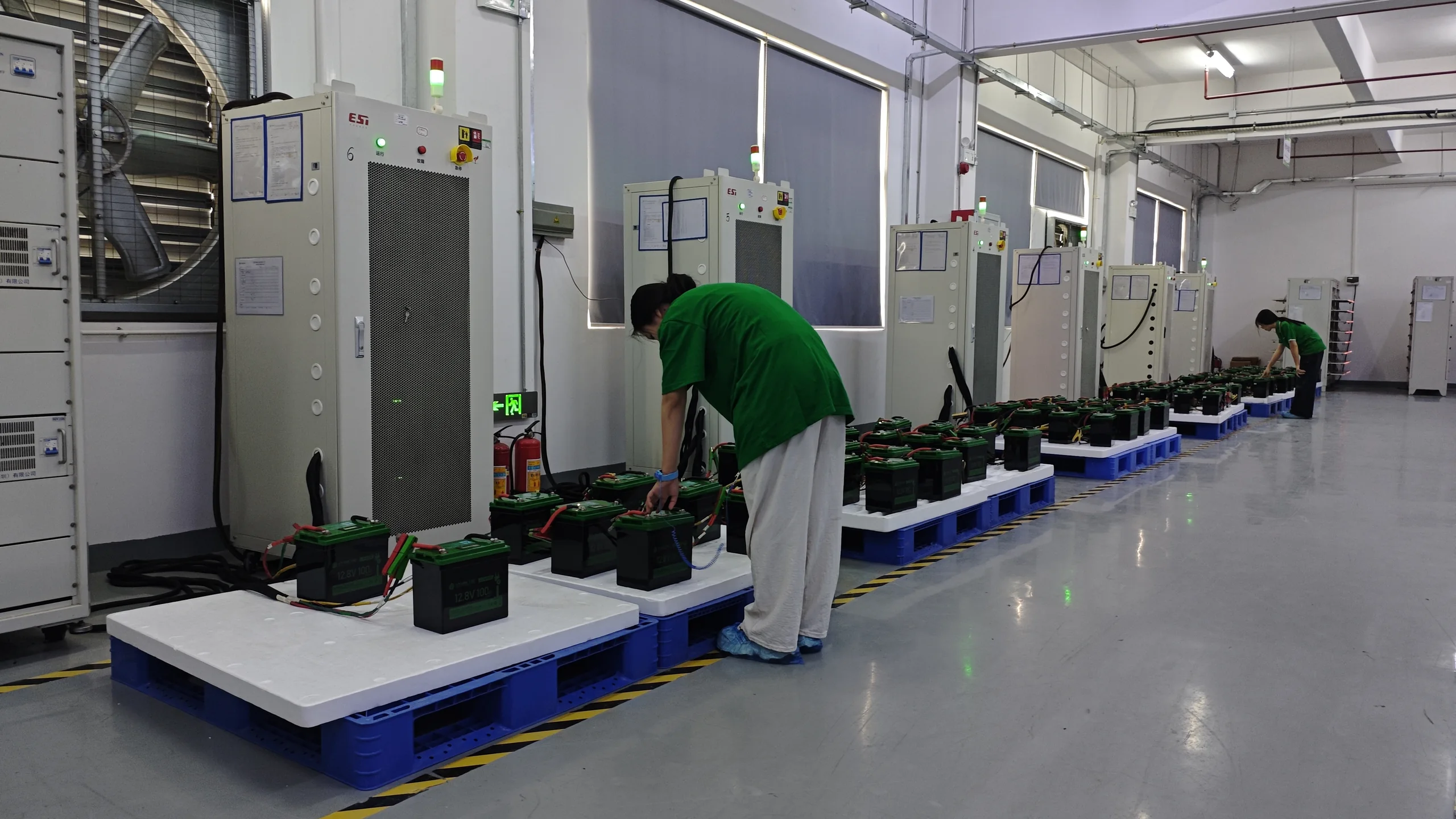

Two Hysincere technicians working beside battery packs connected to test equipment
Battery packs connected to test equipment at Hysincere’s factory.

Whether every pack gets a full capacity test depends on the inspection plan for that model. Aging and functional tests are not the same as a full capacity test. If you need capacity records for each unit or test data shipped with the goods, raise it when you request a quote or samples, so we can agree on the test method and record format.

When you receive a test report, check three things first: which model and version it covers, what the test conditions were, and whether it is a production inspection, a batch sample or a design validation. The same capacity figure means different things depending on the temperature and current it was measured at.

One more point that is easy to mix up: production aging is used to observe how a pack behaves under a defined procedure and to catch defects. It does not prove cycle life. When you look at cycle life data, check the temperature, charge and discharge rates, depth of discharge, and the remaining capacity that counts as end of life. Our LiFePO4 battery lifespan guide covers this in more detail.

The records stay after shipping

Before packing, we check the model, quantity, labels, accessories and any documents agreed in the order. Shipping information is linked to the production batch, key materials, hardware and firmware versions and test results, all managed through ERP and MES records.

You may never need these records, but they matter when something goes wrong. An order number, serial number or batch number leads to the material batches, production version, inspection records and shipping records for that product. If you report a problem, send a photo of the label and tell us which equipment and charger you use and when the problem started. That helps us tell whether it affects a single unit, a whole batch, or only appears under certain conditions.

Custom products have one more layer. Once a sample is approved, the cells and key materials, drawings, BMS hardware and firmware, parameters and inspection standards are locked, and production follows that approved version. Any change to key materials is validated first and then confirmed with the customer.

To see the models we already offer, take a look at our lead-acid replacement batteries.

Discuss a Battery Model or Sample

Tell us what the battery will power and the quantity you need. We can help you review a model, arrange samples and discuss inspection documents.

Cells and Production FAQ

What cells do you use? Are they Grade A?

The actual cell model is listed in the product documents, and cell specifications and batch traceability information are provided per project. "Grade A" is used loosely in the market, and a label or a QR code alone proves very little. What really counts is the cell source, the datasheet, incoming inspection records, consistency of capacity and internal resistance, and whether production keeps to the approved configuration.

Can customers specify the cell brand?

Yes. Cells are normally chosen for capacity, current, temperature range, size, certification and supply. If you specify a brand and model, we assess whether it suits the design and, once confirmed, add it to the bill of materials. If a cell ever needs to change, we explain the differences and get your approval first. Cells are never swapped without notice.

Are the cells connected with copper busbars, aluminum busbars or wires?

It depends on the cell terminal material, the current and the structure. Copper busbars, aluminum busbars, nickel strips and wiring harnesses can all be used, often in different places in the same pack. What matters is an adequate cross-section, low contact resistance, good welding or fastening quality, temperature rise and vibration resistance. If you have specific material or inspection requirements, they can be written into the drawings and bill of materials and then verified by testing.

Can we visit the factory?

Yes. You are welcome to visit our Dongguan factory, or we can arrange a video tour. We suggest focusing on cell sorting, assembly, BMS integration and testing.

The processes and inspections described here are Hysincere's general workflow for battery pack production. Inspection items, test programs and acceptance criteria for a specific model follow that model's process documents and inspection plan.
